Veterans Parkway will be the same as the section constructed north of Arrowhead Parkway. In general, the new roadway will consist of:

  • Three lanes per direction
  • A 32-foot raised median separating the travel lanes
  • Shared use path along the south side of the Parkway
  • Grass boulevard separating the path from the roadway
  • Speed limit of 50 mph.

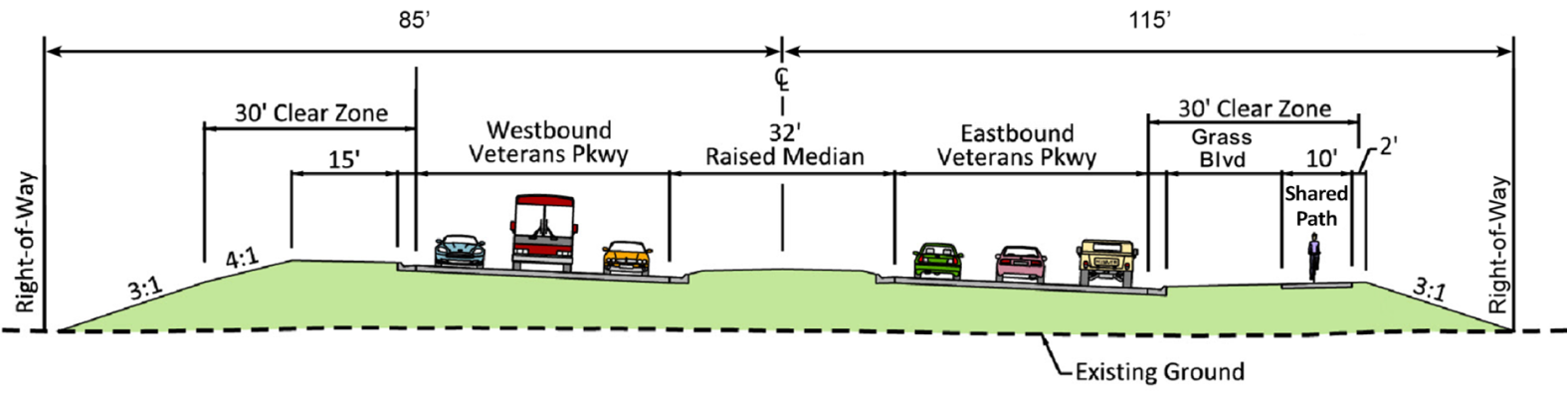

A typical section showing eastbound and westbound traffic on Veterans Parkway. The typical section shows a 30-foot clear zone, a 10-foot shared-use path on the north side of the roadway, and a 32-foot raised, grassy median.

Current Construction

Cliff Avenue to Sycamore Avenue

Construction Timeline: 2025-2026

Components

  • Pedestrian underpasses will be installed between:
    • Cliff Avenue and Southeastern Avenue
    • Southeastern Avenue and Sycamore Avenue
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • Southeastern Avenue
    • Sycamore Avenue
  • An overpass will be installed at the BNSF railroad.

View Construction Details

Click to enlarge.
A timeline showing that construction begins in April 2025 and construction activities in spring, summer and fall of 2025 will include dirt work, storm sewer, and utilities on South Veterans Parkway and Southeastern Avenue, as well as paving on Southeastern Avenue. The timeline also shows that construction activities in spring, summer, and fall of 2026 will include dirt work and utilities on Sycamore Avenue and paving on South Veterans Parkway and Sycamore Avenue. The construction activities are weather and schedule permitting.

Future Construction

Note: Design for segments not under construction are not final and are subject to change.

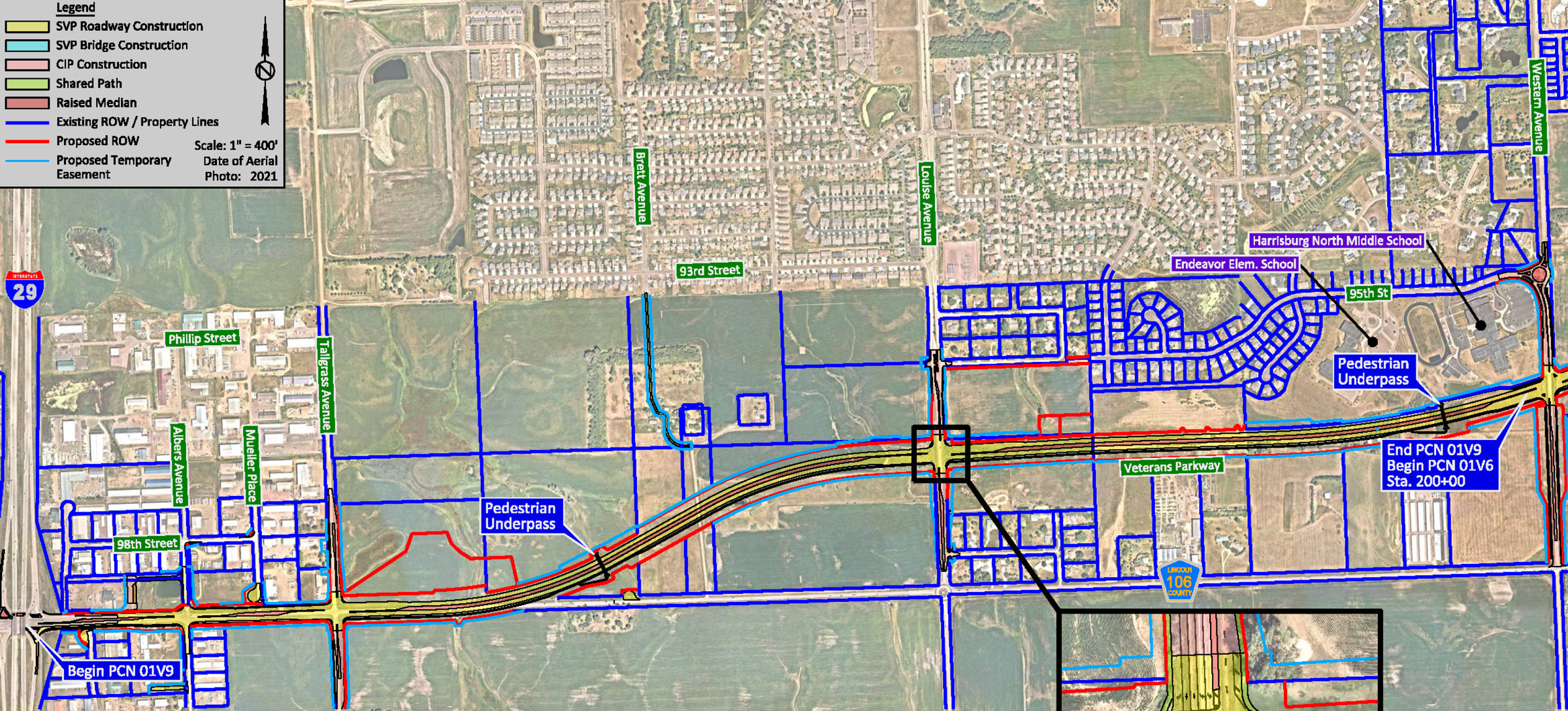

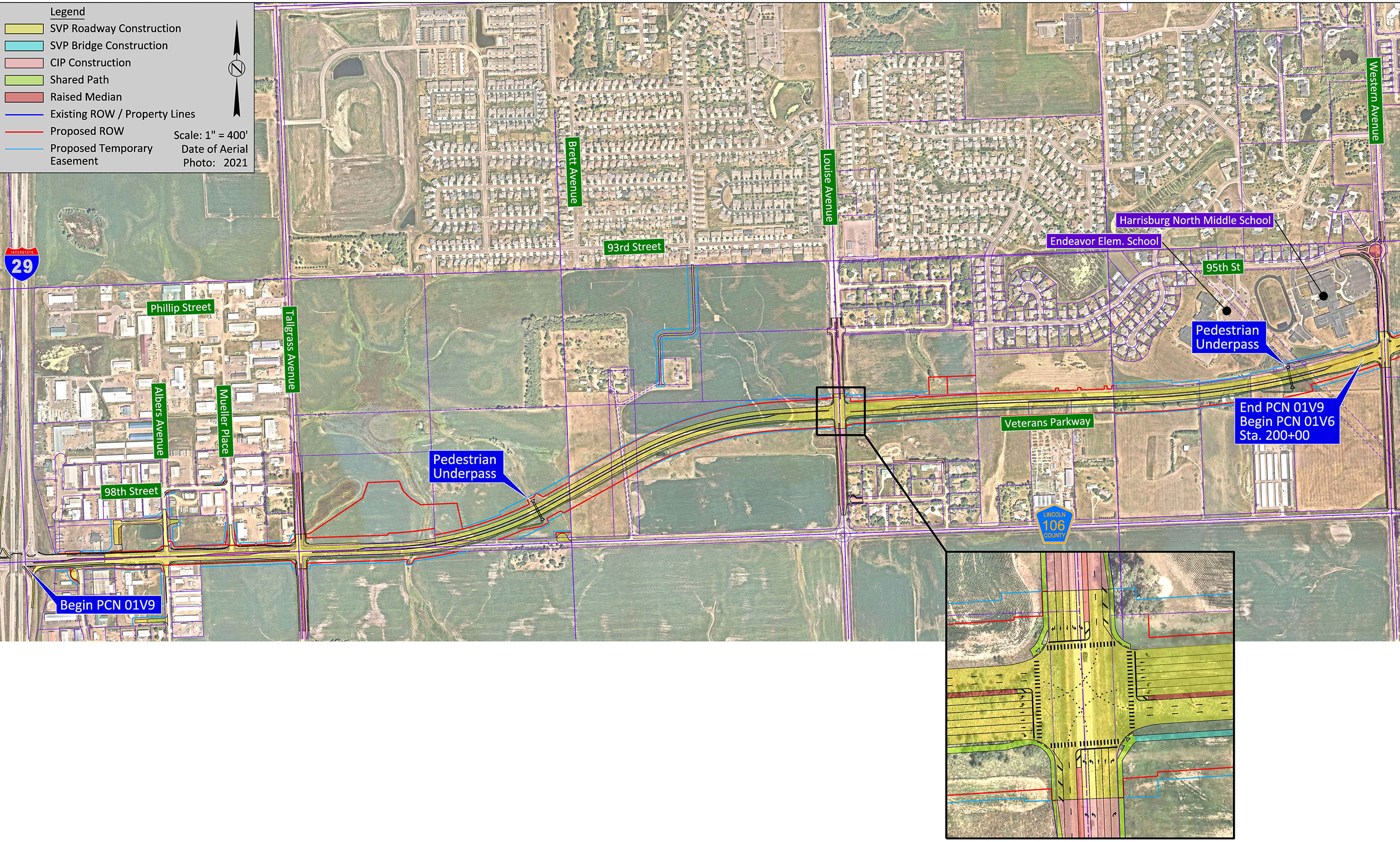

I-29 to Western Avenue

Design: Completed

Construction Timeline: 2027 - 2028

Components:

  • Pedestrian underpasses will be installed between:
    • Tallgrass Avenue and Louise Avenue
    • Louise Avenue and Western Avenue near Harrisburg schools
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • Albers Avenue
    • Tallgrass Avenue
    • Louise Avenue
Click to enlarge.

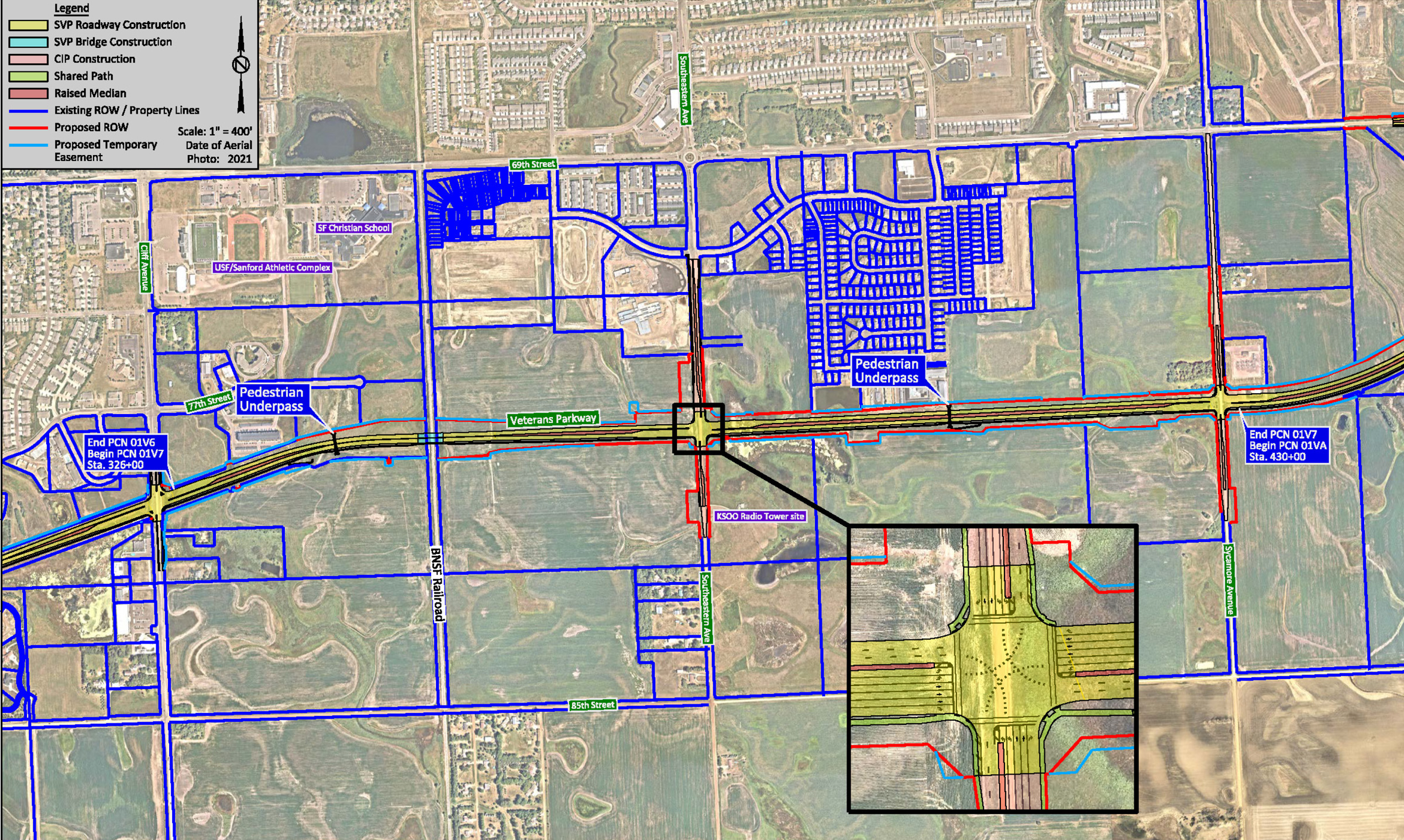

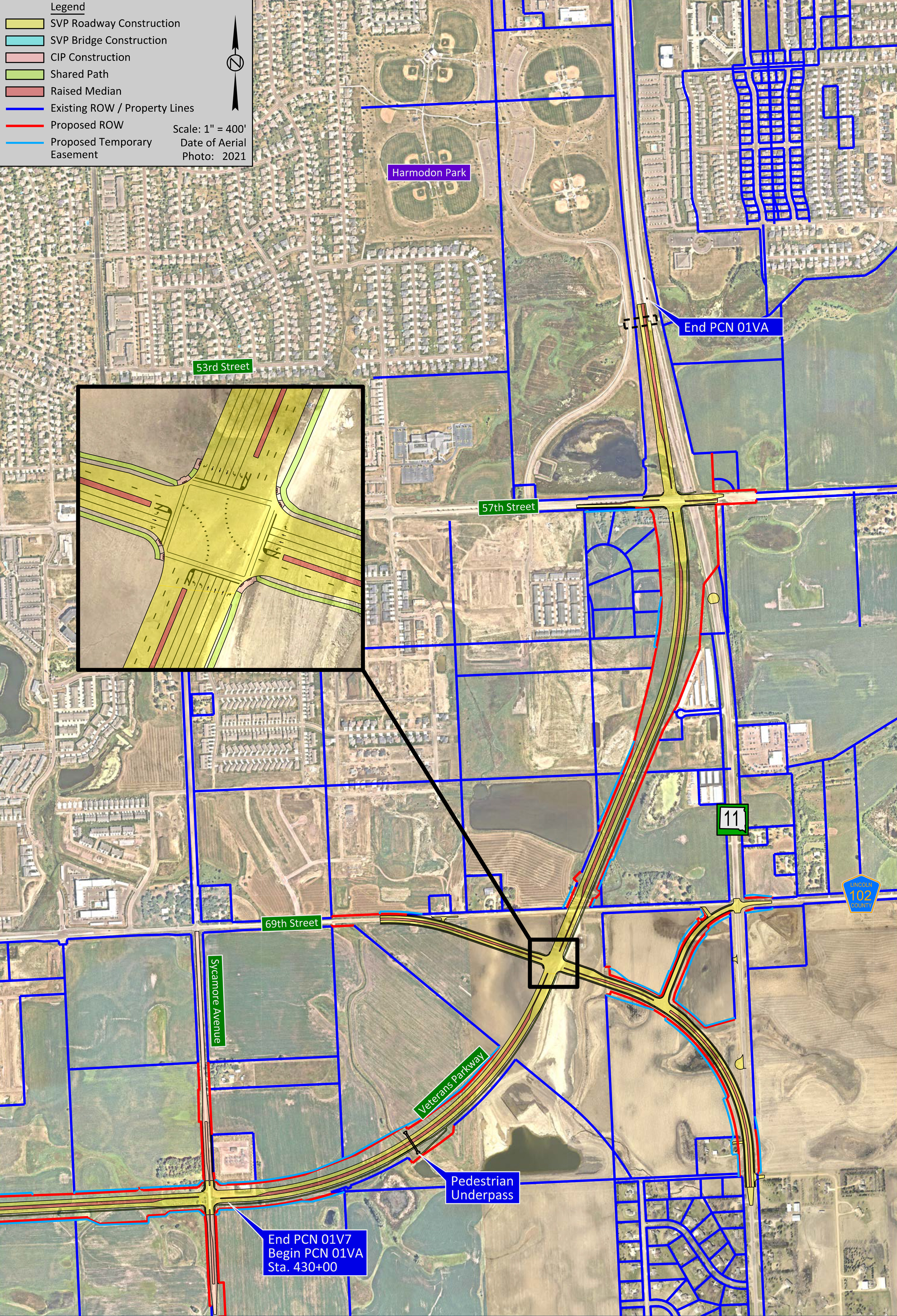

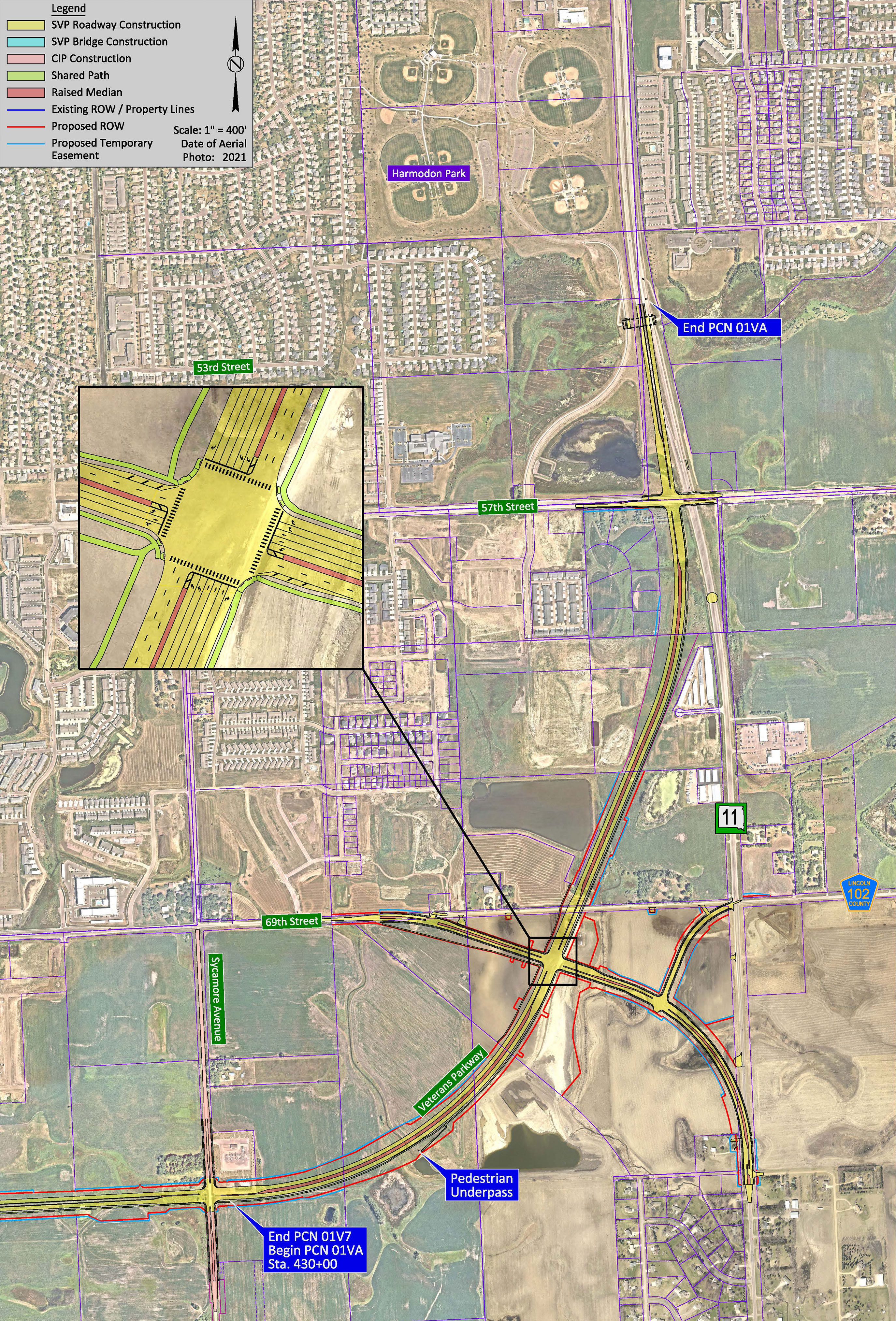

Sycamore Avenue to 57th Street

Design: Complete

Construction Timeline: 2027 - 2029

Components:

  • Pedestrian underpasses will be installed between:
    • Sycamore Avenue and 69th Street
  • ADA-compliant traffic signals will be installed at the intersections of Veterans Parkway and:
    • 69th Street
    • 57th Street
  • Rehabilitation of the pedestrian underpass to Harmodon Park. See Harmodon Park Map Detour here.
Click image to enlarge

Completed Construction

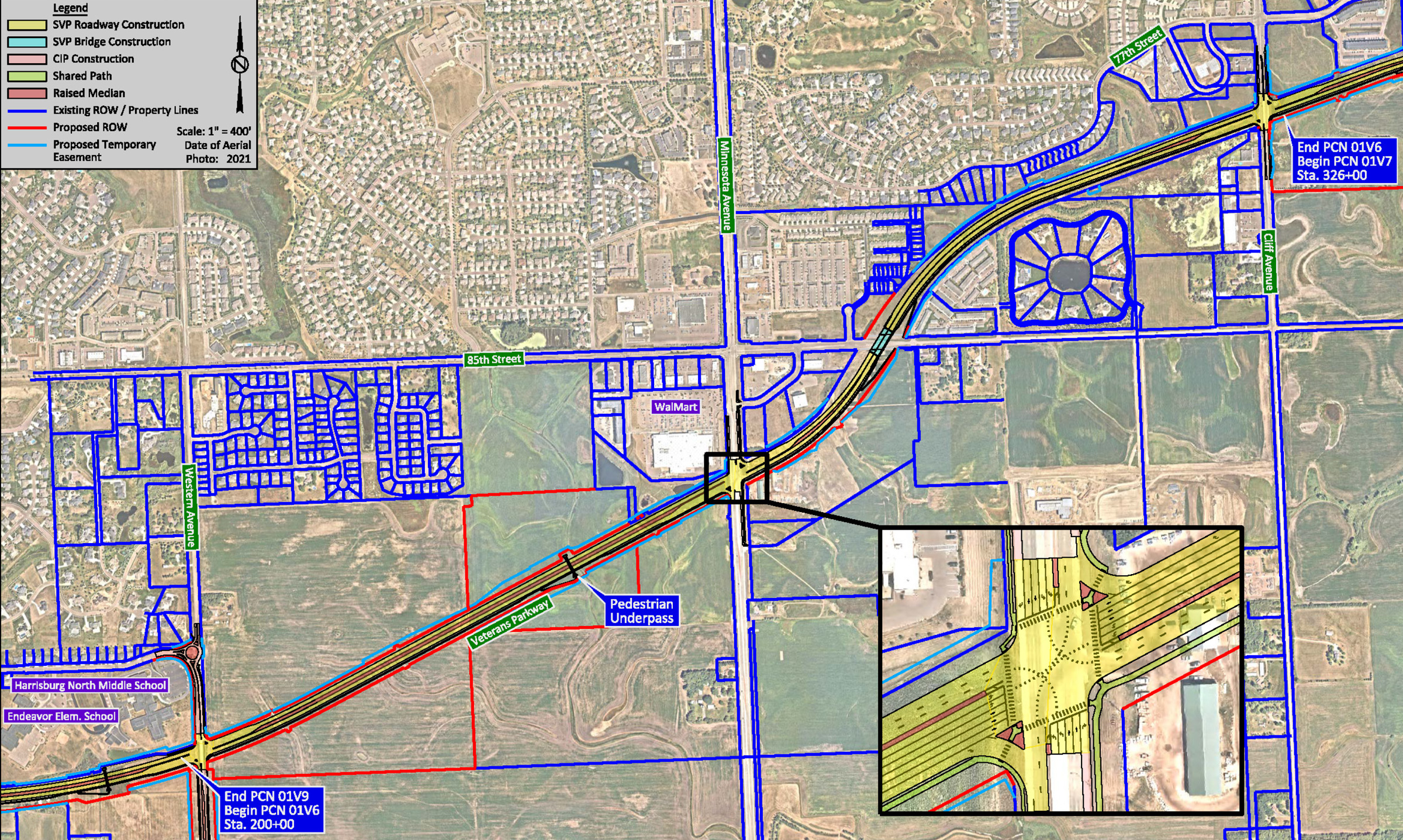

Western Avenue to Cliff Avenue

Components

  • A pedestrian underpass was installed west of Minnesota Avenue.
  • Traffic signals at Western Avenue, Minnesota Avenue, and Cliff Avenue are compliant with the Americans with Disabilities Act (ADA).

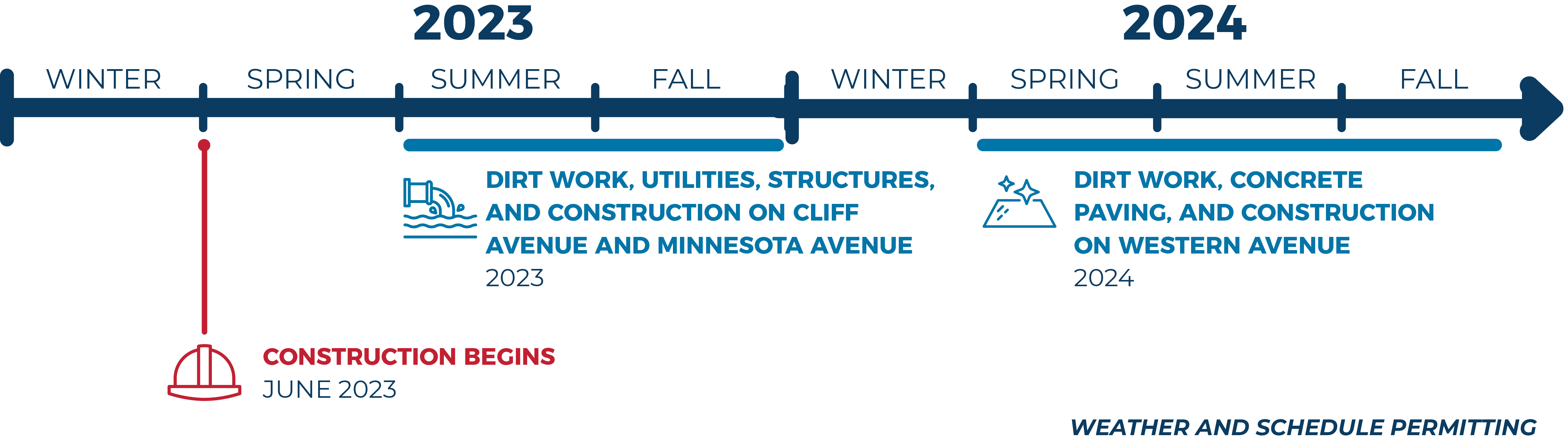

  • Construction Begins spring 2023
  • Dirt Work, Utilities and road work on Cliff Avenue during spring 2023
  • Road Work from winter 2023 through the fall 2024

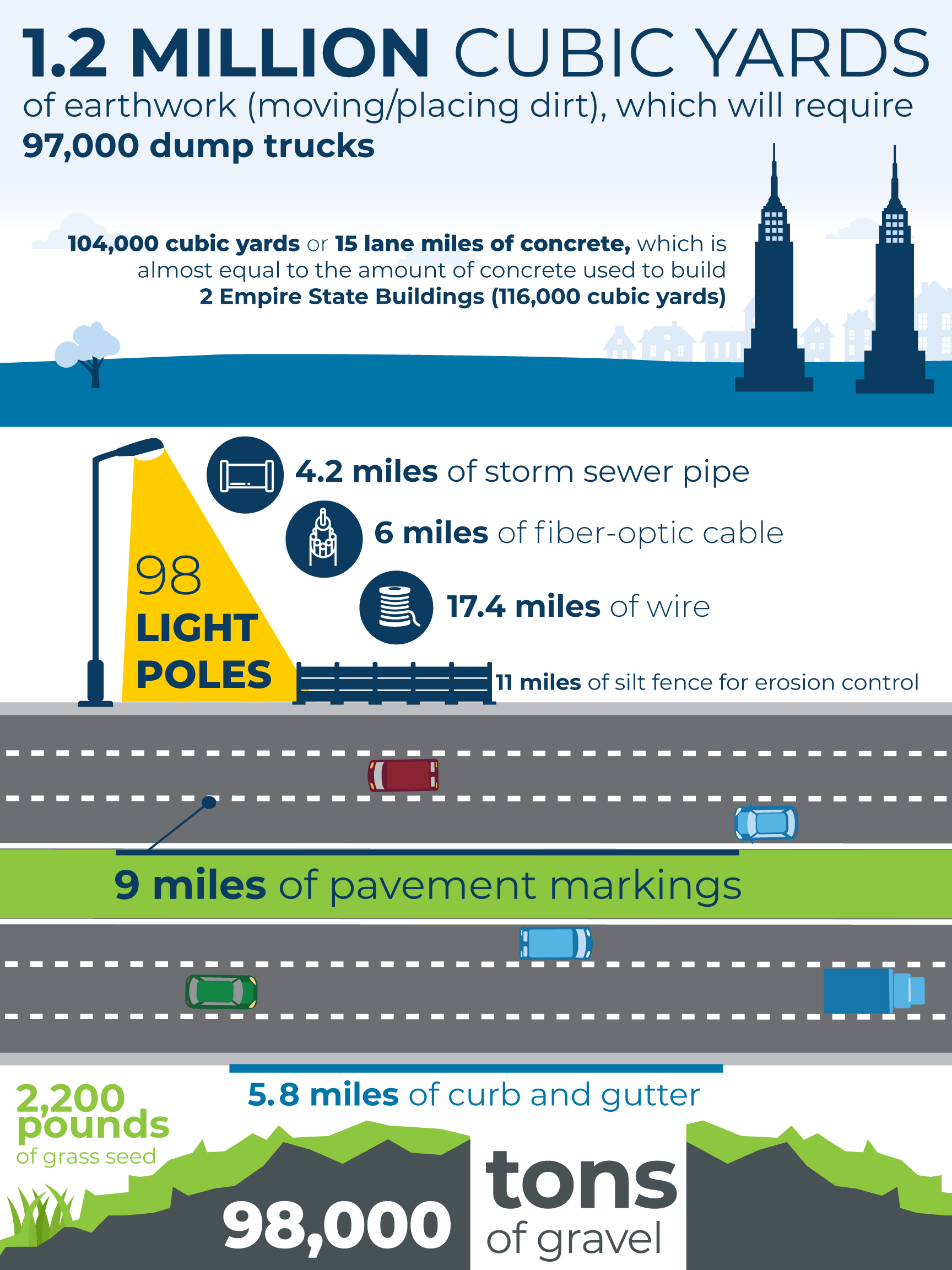

Construction Quick Facts: Western Avenue to Cliff Avenue

Click to enlarge.
